Millbrook Park - South Point 138-kV Transmission Line Rebuild Project


AEP Transmission representatives plan to increase electric reliability in Scioto and Lawrence counties by updating the local electric transmission system. The Millbrook Park-South Point 138-kV Transmission Line Rebuild Project involves upgrading about 35 miles of 138-kilovolt (kV) power line.

The existing transmission line consists of 90-year-old aging lattice towers. The infrastructure has shown significant deterioration resulting in service interruptions. Upgrading to modern steel poles reduces the need for ongoing power line maintenance and improves electric reliability.

Project Updates

Fall 2026:

Beginning in October, AEP Transmission crews and contractors plan to begin pre-construction activities, including surveys to collect soil samples at select locations along the transmission line route. Crews may need to clear trees in advance to access these locations. These surveys are expected to continue through the start of construction.

Construction along the transmission line route is expected to begin later this year and continue through late 2030, subject to weather and other factors. Work will be completed in four phases, beginning at Millbrook Park Substation and concluding at South Point Substation. The interactive map above details the four phases.

  • Phase 1: Late 2026-Spring 2029
  • Phase 2: Early 2027-Fall 2029
  • Phase 3: Fall 2027-Summer 2030
  • Phase 4: Late 2028-Late 2030

During these activities, landowners may see crews walking or using all-terrain vehicles to access your property. Whenever possible, crews will use existing roads, lanes and access paths to minimize impacts. AEP Transmission representatives will work with landowners to address those impacts, including restoration or reimbursement, as appropriate.

Contract Land Staff (CLS) continues to serve as AEP Transmission’s right-of-way representative for this project. For questions or concerns, please contact CLS Right-of-Way Agent James Smith at 304-544-3376 or james.smith@contractlandstaff.com. You may also submit questions with the comment form at the bottom of this page.

CLS right-of-way agents will be reaching out to affected property owners to coordinate forestry work, access road installation, construction and restoration efforts.

Project Releases

South Point – Portsmouth 138 kV (Millbrook Park – South Point) Rebuild Project Letter of Notification Application (PDF)

South Point – Portsmouth 138 kV (Millbrook Park – South Point) Rebuild Project Public Notice (PDF)

Timeline

Open project timeline modal

Structures

Open project structure modal

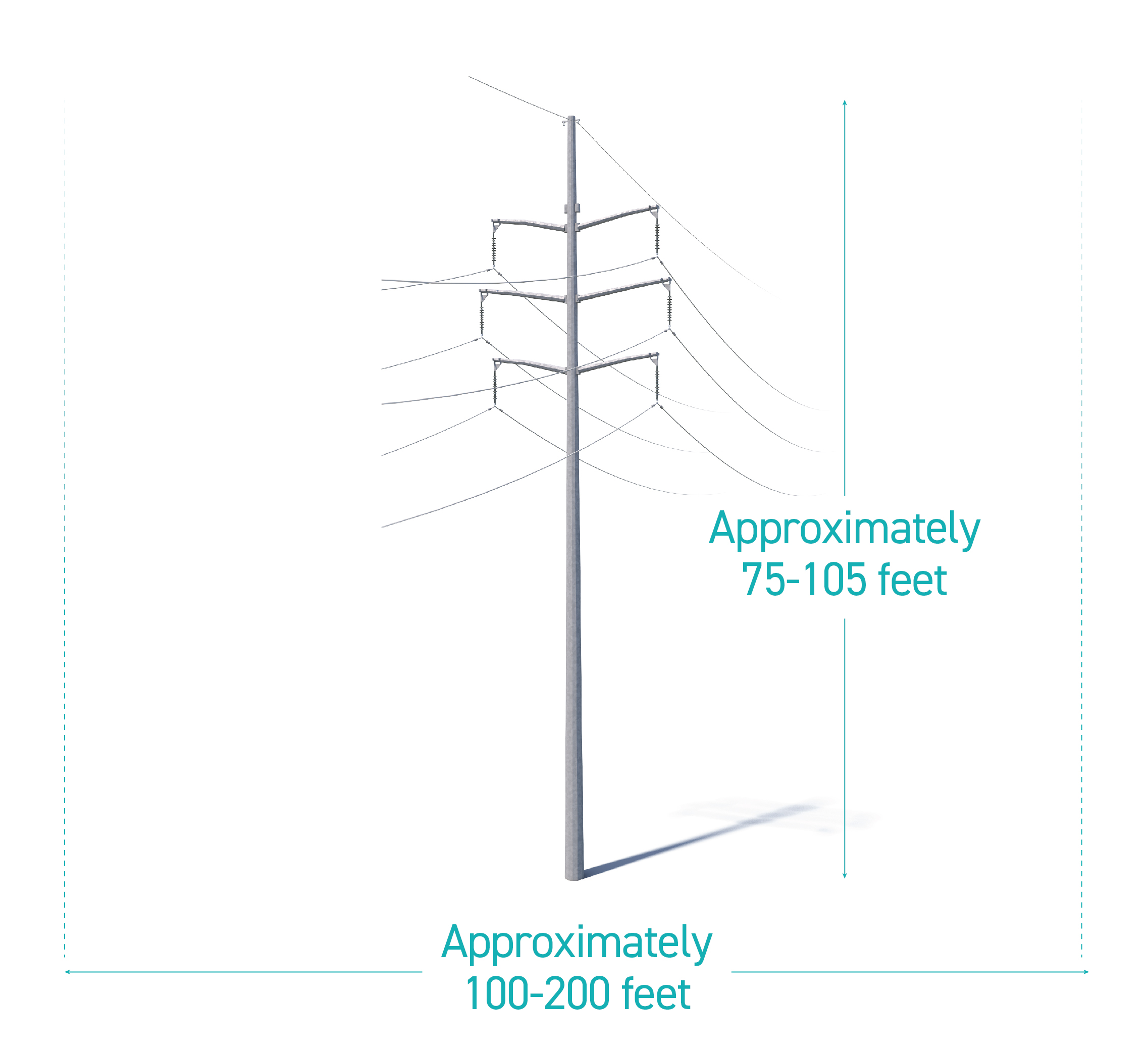

The project involves the use of single, steel poles.

Typical Pole Height Range: 75-105 feet*
Right-of-Way Width Range: 100-200 feet*

* Exact structure, height and right-of-way may vary
