Duncan - Rush SpringsTransmission Improvements Project


Public Service Company of Oklahoma (PSO) representatives plan to strengthen the electric system by rebuilding an aging transmission line in Stephens and Grady counties. Crews plan to start construction in fall 2025 and conclude in late spring 2026.

The project involves rebuilding about 25 miles of 138-kilovolt transmission line in Stephens and Grady counties.

Project Updates

Spring 2024: As this project has evolved, the timeline has shifted. PSO representatives plan to start construction activities in fall 2025 and conclude in late spring 2026.

Spring 2023: Due to challenges with the supply chain, PSO representatives decided to rebuild this line using mostly concrete single-pole structures instead of steel. PSO representatives expect pre-construction activities to start in late summer of this year, with transmission line construction starting in early fall. Crews plan to finish construction in late spring 2024.

Timeline


Project Timeline


Structures

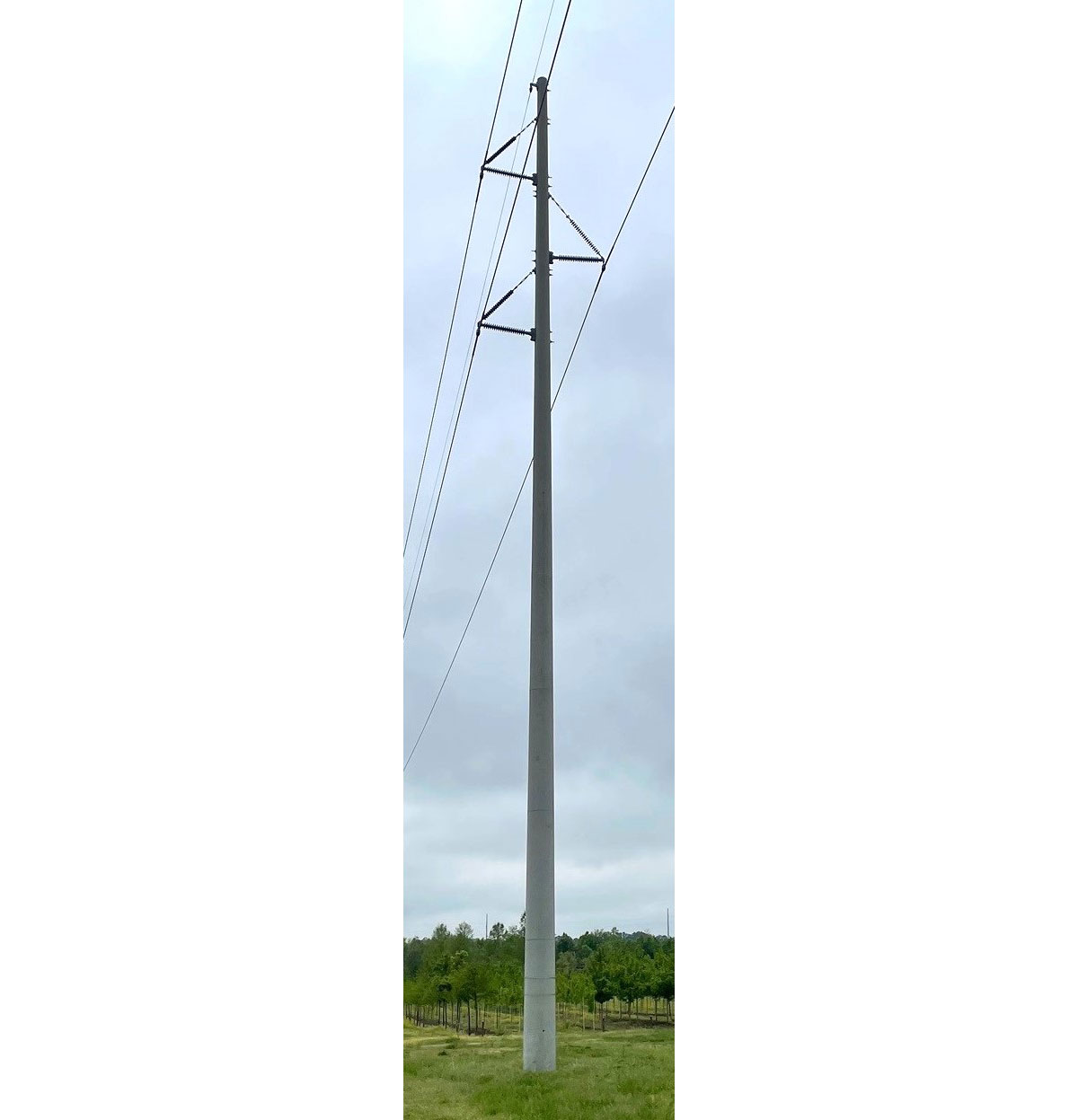

Structure

PSO crews plan to install concrete single-pole structures.

Typical Structure Height: Approximately 85 feet*
Typical Distance Between Structures: Approximately 600 feet*
Typical Right-of-Way Width: 100 feet

Exact structure, height, and right-of-way requirements may vary.

Resources

Property Easements Project Fact Sheet Project Map Access Roads Field Activities

Public Service Company of Oklahoma serves 538,000 customers in Oklahoma.

www.PSOklahoma.com

Matthew Hames

Project Outreach Specialist
918-237-6736
mchames@aep.com

Submit a Message

*Required field. By clicking submit, you agree to AEP's Privacy Policy.

Please complete the ReCAPTCHA to submit the form. If you have difficulty, use the audio challenge option.

Paper plane

Your message has been sent! We'll be in touch shortly.
